June 2023 Construction Update - South Mountain
PROGRESS TO DATE
Exterior work continues on roofing, concrete, insulation, and brick veneer
Interior work continues including painting, ceilings, masonry and tiling work
Front office remodeling is about 50% complete
Work on fire alarm upgrades continues
May 2023 Construction Update - South Mountain
PROGRESS TO DATE

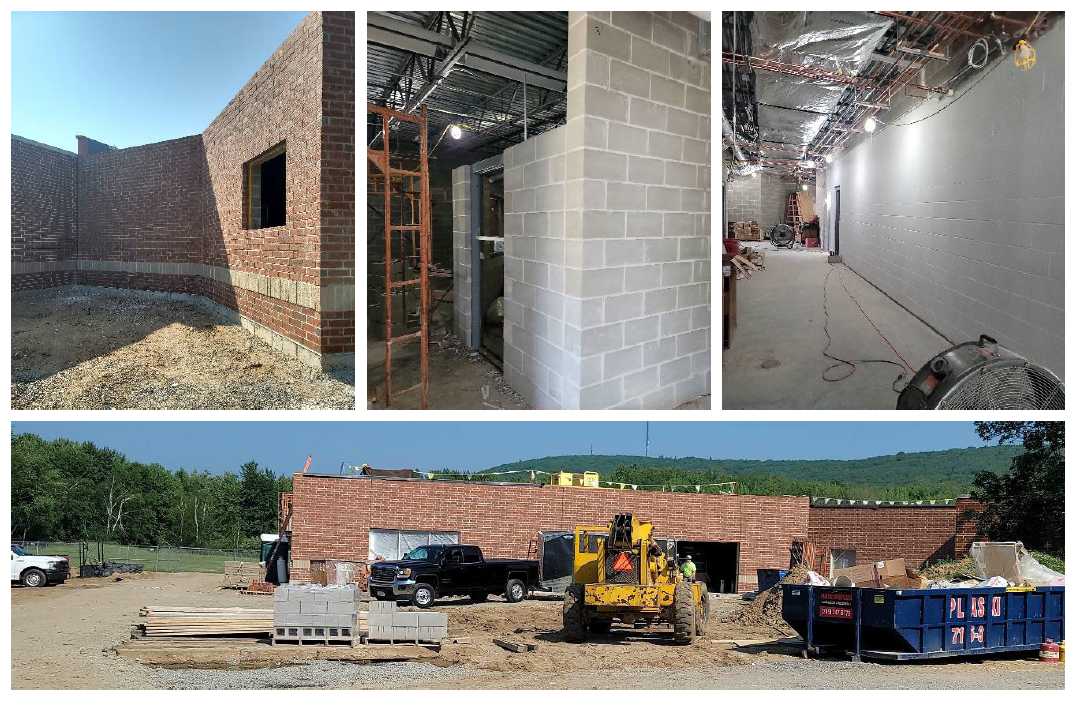

95% of EPDM roofing in Area B is complete
Completed slab preparation and exterior insulation for Area B
75% of HVAC rough in for Area B is complete
Completed construction of bearing masonry in Area C
Installed bar joist and metal deck in Area C
50% of EPDM roofing is complete in Area C
Completed plumbing tie in from existing building
75% of fire alarm upgrades in existing building are complete
Design Work 95% Complete at South Mountain

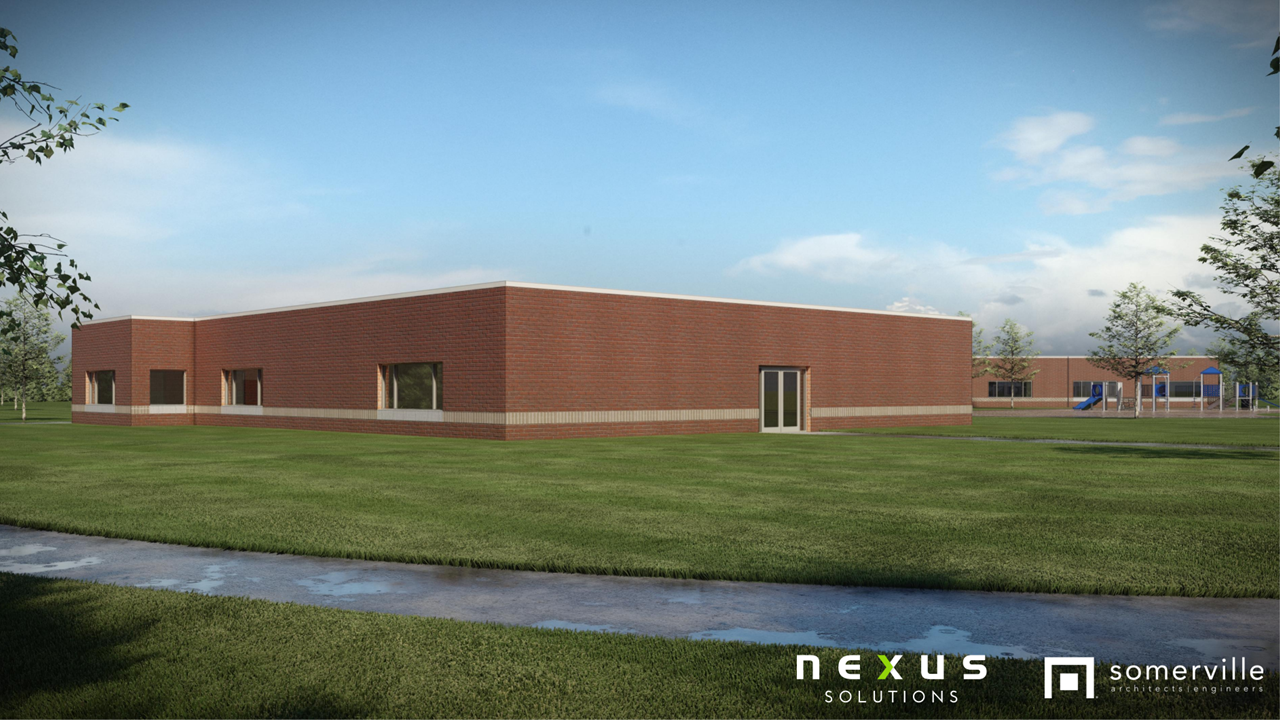

Exterior Rendering
As South Mountain’s Design process nears completion, plans are coming together nicely. Interior finishes for windows, doors and flooring have been selected to match existing finishes.
Areas of work at South Mountain include:
two classroom additions to create six new rooms, including two for kindergarten
upgrading front entry and ADA access (doors, cubbies)
LED lighting,
air handling units
fire and safety systems
plumbing
Design Work is 50% Complete at South Mountain
South Mountain Design is halfway through the process and, after weeks of design and user group meetings, plans are coming together nicely. A notable development was the decision to relocate the existing walking path and fire lane. Click here to see design plans to date.
