June 2023 Construction Update - Stettin Elementary

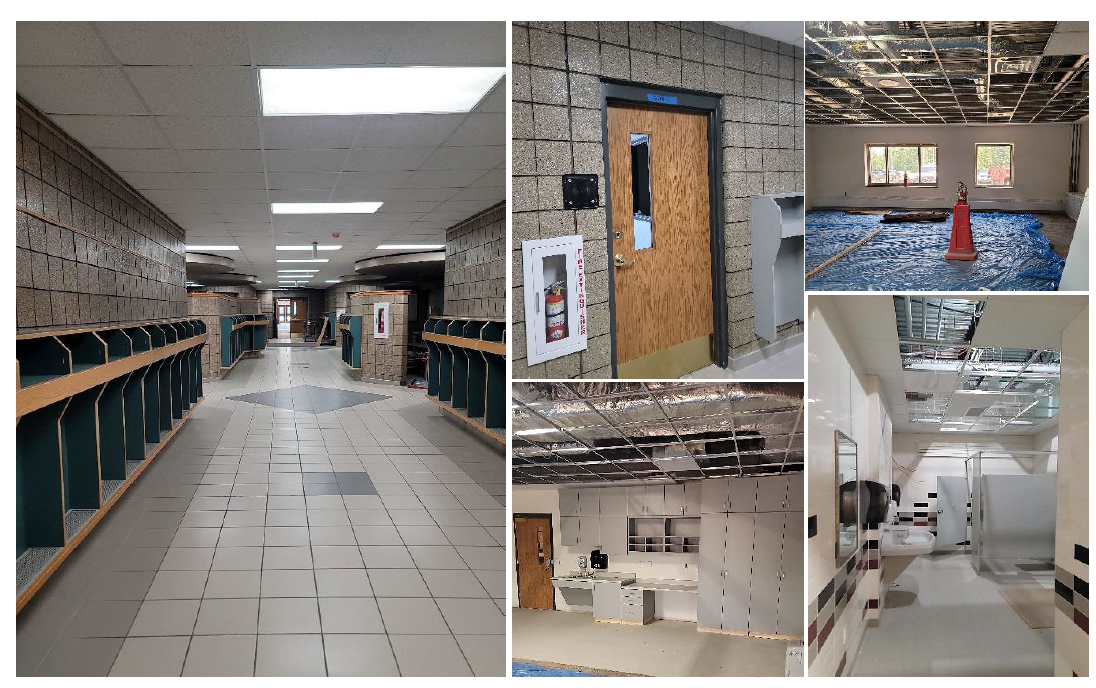

PROGRESS TO DATE
Majority of interior doors and windows are installed
95% of interior painting is complete
95% of HVAC system for addition is installed
85% of casework and flooring are installed in classrooms and corridors
85% of electrical system for addition is complete
Plumbing and bathroom floor and wall tile complete
May 2023 Construction Update - Stettin Elementary

Design Work is 95% Complete at Stettin Elementary
As Stettin’s Design progresses to the 95% complete, plans are coming together nicely. Interior finishes for windows, doors and flooring have been selected to match existing finishes.
Areas of work at Stettin include LED lighting, air handling units, fire and safety systems, plumbing, casework and cubbies.
Design Work is 50% Complete at Stettin Elementary
As Stettin’s Design progresses to the halfway mark in the process, and after weeks of design and user group meetings, plans are coming together nicely. While the floor plan for the classroom addition and secure entry remained the same, the playground was relocated. Click here to see design updates.
